Royal Arcade redevelopment
Following a comprehensive procurement exercise, Peveril Securities has been selected as the council’s development partner for the Royal Arcade scheme in Crewe town centre.
A development agreement was signed in October 2020 to deliver a leisure-led mixed-use development on the site, phase one of which will include a new bus station and multi-storey car park.
Royal Arcade Development Site Timeline
Royal Arcade Development Site Timeline
Milestone | Expected start / end |
Started on site
|
April 2022
|
Demolition of former bus garages
|
April 2022 – August 2022
|
Temporary bus station construction
|
August 2022 – January 2023
|
Temporary bus station operational
|
January 2023 – December 2023
|
Demolish existing bus station buildings
|
January 2023 – February 2023
|
Construct new bus station and multi-storey car park
|
February 2023 – May 2024
|
New bus station operational
|
Expected May 2024
|
New multi-storey car park operational
|
Expected May 2024
|
Bus Station

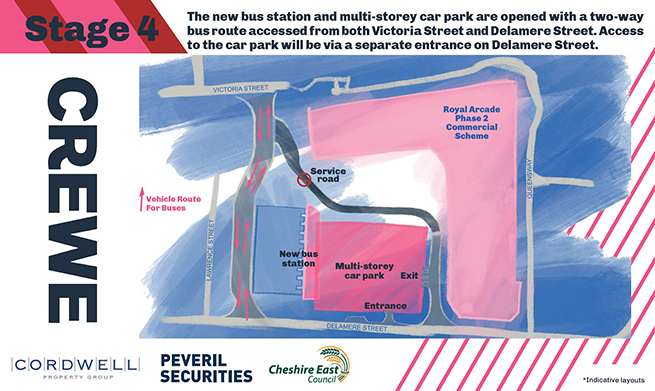

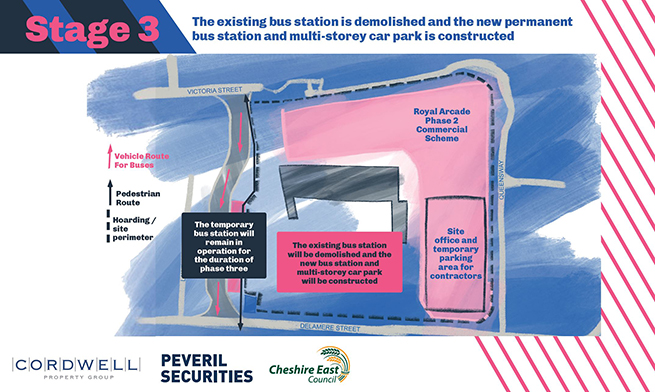

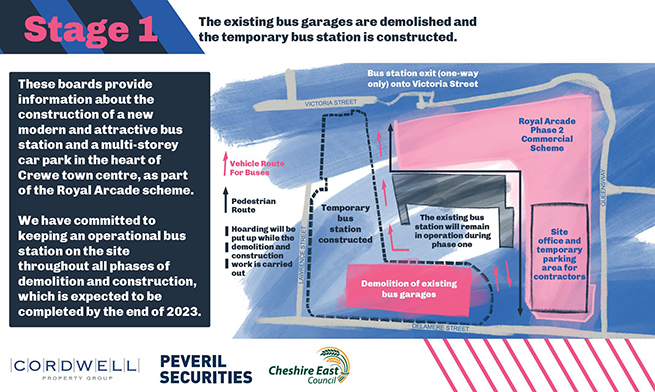

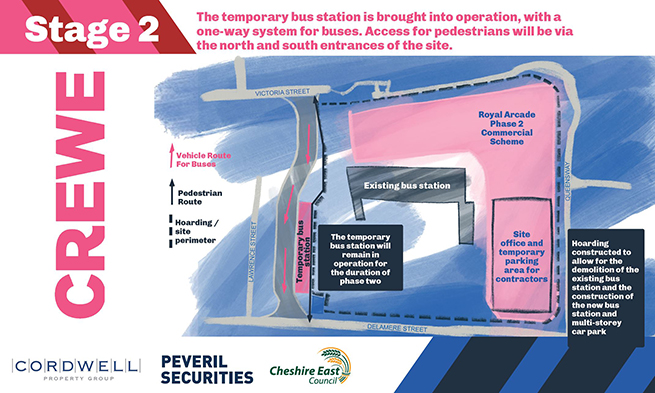

The new bus station and multi-storey car park will be completed in four stages. The images below give you more information about the works that will take place.
We have committed to keeping an operational bus station on the site throughout all phases of demolition and construction.
Page last reviewed: 11 March 2024
